Pool refurbishment covers the work that restores an existing pool’s surface, tile, coping, plumbing, and equipment to safe, attractive working condition — without tearing out the shell and starting over. Think of it as the difference between renovating a kitchen and demolishing the house. A focused refurbishment typically runs $10,000–$35,000 for mid-range work, while a full renovation that replaces surface, tile, coping, and all major equipment can reach $50,000 or more depending on size, materials, and what the inspection turns up. New construction in most U.S. markets costs substantially more.

Three things to do right now:

Key Takeaways

A full pool refurbishment that replaces surface, tile, coping, and equipment can extend a pool’s useful life by 20–30 years at a fraction of new-construction cost — but only if the scope is built on a professional inspection, not a visual estimate.

Point Details
Start with an inspection Hidden structural issues like rebar corrosion and plumbing failures determine the real scope and budget.
Budget with contingency Reserve 15–25% above your base estimate for hidden issues found during demolition or structural work.
Surface choice drives lifespan Pebble and aggregate finishes last 15–25 years vs. 8–15 years for standard plaster — a meaningful long-term cost difference.
Bundle equipment upgrades Variable-speed pumps cut energy use by 50–90%; installing them during resurfacing avoids a second drain and mobilization cost.
Longhorn Pools for Austin projects Longhorn Pools provides inspection-driven renovation scopes, permit management, and full-project coordination across Austin and the Texas Hill Country.

Table of Contents

What does pool refurbishment actually involve?

Pool renovation is the broader industry term; “pool refurbishment” describes the same general process of restoring an existing pool rather than replacing it. The two phrases are used interchangeably by most contractors. Refurbishment focuses on restoring appearance and function, while a full renovation may also change the pool’s shape, add features, or rework major systems. Knowing which one you need starts with an honest look at what you’ve got.

Refurbish vs. replace: how to read the signals

Refurbishment is usually the right call when the shell is structurally sound and the problems are limited to surface wear, aging tile, outdated equipment, or cosmetic deterioration. Replacement makes more sense when the shell has shifted significantly, soils have moved enough to crack the structure, or multiple major systems have failed simultaneously and the repair cost approaches new-build pricing.

Here’s a diagnostic checklist you can walk through before calling anyone:

A professional inspection changes the picture significantly. Inspectors check rebar condition, run pressure tests on plumbing lines, look for underground leaks, assess shell movement, and evaluate soil conditions around the pool. What looks like a surface problem from the deck can turn out to be a rebar corrosion issue that needs structural repair first.

Pro Tip: Before the inspector arrives, photograph every visible crack, stain, and equipment label. Note the last resurfacing date and gather any repair invoices. This gives the inspector a baseline and helps you catch scope creep later.

How much does pool refurbishment cost?

Budget planning is where most homeowners get tripped up, usually because the first quote they receive doesn’t account for what the inspection finds. Here’s a realistic framework.

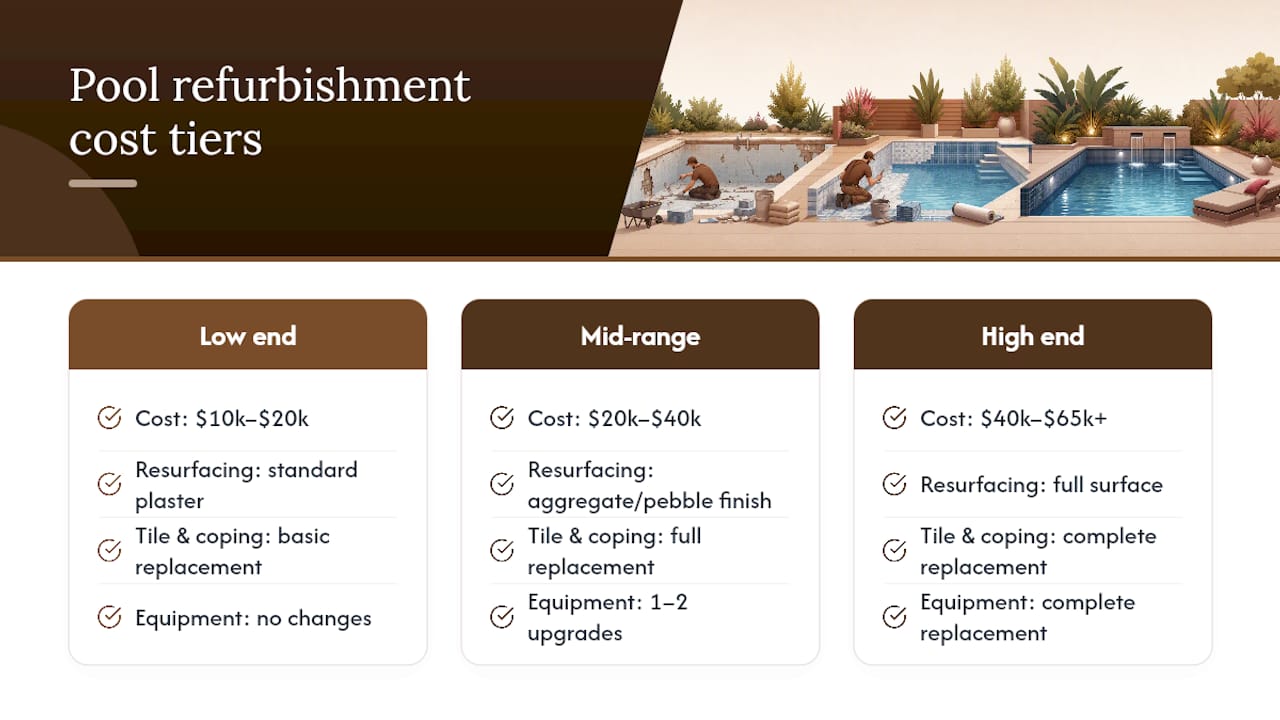

Low end ($10,000–$20,000): Resurfacing only (standard plaster), basic tile replacement, minor coping repairs, and no equipment changes. Suitable for pools with sound shells and relatively recent equipment.

Diagram showing pool refurbishment cost ranges and scopes

Mid-range ($20,000–$40,000): Aggregate or pebble finish, full tile and coping replacement, one or two equipment upgrades (pump, filter, or heater), and minor deck work. This is where most residential refurbishments land.

High end ($40,000–$65,000+): Full surface, tile, coping, and complete equipment set replacement; deck resurfacing or expansion; automation, LED lighting, and possible water feature additions. Often overlaps with a full pool renovation.

Line-item cost breakdown

Line Item Typical Range
Resurfacing — standard plaster $5,000–$10,000
Resurfacing — aggregate/pebble/quartz $10,000–$20,000
Waterline tile replacement $1,500–$5,000
Coping replacement $2,000–$7,000
Variable-speed pump (installed) $1,200–$2,500
Filter replacement $800–$2,000
Heater replacement $1,500–$4,500
Automation system $1,500–$4,000
Deck resurfacing $3,000–$10,000
Permits and inspections $200–$1,500

A full renovation that replaces surface, tile, coping, and equipment can extend a pool’s useful life by 20–30 years and costs substantially less than new construction in most markets. That math alone often makes refurbishment the obvious choice.

Remodeling can also contribute to home resale value depending on local conditions and the specific upgrades completed, which is worth factoring into your return-on-investment thinking.

Budgeting checklist:

Hidden issues that commonly inflate costs include rebar corrosion (which requires chipping out concrete and treating or replacing steel), underground plumbing failures (pressure testing can find these before work starts), and soil settlement around the shell. Building inspection-driven allowances directly into your contract terms is the cleaner way to handle these than negotiating change orders mid-project.

What’s the step-by-step process for a pool refurbishment?

The sequence below covers a typical full refurbishment. Resurfacing-only projects skip several steps, but the inspection and permit phases still apply.

  1. Professional inspection and scope report. The inspector documents shell condition, rebar, plumbing, equipment, and safety compliance. This report becomes the foundation of your contractor quotes.
  2. Permit applications. Most structural work, plumbing changes, and electrical upgrades require permits. Submit early — permit lead times vary widely by jurisdiction and can delay your start date by weeks.
  3. Drainage decision. Full resurfacing requires draining the pool. Underwater leak detection and localized repairs can sometimes avoid a full drain, protecting the shell from hydrostatic pressure risks. Your contractor should assess this before defaulting to a drain.
  4. Demolition and edge work. Old tile, coping, and deteriorated plaster are removed. Deck sections that need replacement come out at this stage.
  5. Structural repairs. Cracks are chiseled out and filled with hydraulic cement or epoxy. Rebar corrosion is treated or replaced. This is the step most likely to expand scope based on what the demo reveals.
  6. Plumbing and electrical upgrades. New lines, fittings, or conduit are run while the pool is open. This is the right time to upgrade to a variable-speed pump and add automation wiring.
  7. Tile and coping installation. New waterline tile and coping are set and grouted before the surface goes in.
  8. Surface application. New plaster, aggregate, or pebble finish is applied and troweled. Curing begins immediately.
  9. Refill and startup chemistry. The pool is refilled slowly and startup chemistry is balanced over several days to protect the new surface.
  10. Equipment installation and commissioning. New pump, filter, heater, and automation are installed and tested.
  11. Final inspection. The permit inspector signs off, and your contractor walks you through the finished work.

Resurfacing-only projects typically take 1–2 weeks from drain to swim-ready. A full refurbishment with structural repairs and equipment replacement often runs 3–6 weeks, and weather or permit delays can extend that. Structural repair and plumbing work can overlap with tile and coping installation to compress the schedule.

One safety note: proper disposal of old plaster, tile, and chemical waste is required by most local codes. A reputable contractor handles this as part of the project, but confirm it’s in the scope before signing.

Which interior surface is right for your pool?

The surface you choose affects how the pool looks, how it feels underfoot, how often you’ll need to resurface, and what you’ll spend on maintenance over time. Here’s how the main options compare.

Close-up of varied pool surface texture samples

Surface Typical Lifespan Pros Cons Relative Cost
Standard white plaster 8–15 years Low upfront cost, smooth finish Stains easily, rough when worn, limited color options $
Colored plaster 8–15 years More color variety than white Same durability limits as standard plaster $–$$
Quartz aggregate 12–20 years Stain-resistant, smooth feel, good color range Higher cost than plaster $$
Pebble/aggregate 15–25 years Longest lifespan, natural look, very durable Rougher underfoot, higher cost $$–$$$
Fiberglass (shell replacement) 20–30 years Smooth, algae-resistant, low maintenance Requires full shell replacement, color limited $$$$
Vinyl liner 7–15 years Smooth, many patterns, lower cost for above-ground Tears, fades, requires full liner replacement $–$$

Aggregate and pebble finishes typically last 15–25 years compared to 8–15 years for standard plaster, making them a better long-term value for most homeowners even at higher upfront cost.

A few practical notes:

Which equipment upgrades are worth doing during refurbishment?

The short answer: variable-speed pumps, right-sized filters, and smart automation. These three upgrades deliver the clearest return on investment and are far simpler to install while the pool is already open for resurfacing.

Upgrade checklist:

Coordinating equipment work with resurfacing is the key scheduling insight here. Doing it separately means draining the pool twice, paying mobilization costs twice, and disrupting your yard twice. Bundle it.

What permits do you need, and what hidden problems should you expect?

Most full resurfacing projects and all structural or plumbing work require permits. The specific requirements vary by city and county, so check with your local building department early — permit lead times can run anywhere from a few days to several weeks, and starting work without a permit can result in fines or required demolition.

Typical permit checklist:

Your contractor typically pulls these permits as part of the project. Confirm this in writing before work starts. Permit fees generally run $200–$1,500 depending on the scope and jurisdiction.

Common hidden issues that change scope:

Pro Tip: Ask your contractor to include a written allowance for hidden structural work in the contract — a line item that covers up to a defined dollar amount for unexpected findings without requiring a full change order. This protects both parties and keeps the project moving.

How long does pool refurbishment take, and when should you schedule it?

A resurfacing-only project typically runs 1–2 weeks from drain to swim-ready. A full refurbishment with structural repairs, equipment replacement, and deck work usually takes 3–6 weeks. Permit delays, material lead times, and weather can push either timeline out.

Season matters more than most homeowners expect. Here’s the practical breakdown:

For Austin and Texas Hill Country homeowners, fall and winter are the clear winners. The mild climate means curing conditions are good, and you’ll be swim-ready well before the heat arrives in May.

Site prep checklist before work starts:

How do you choose the right pool contractor?

The single most important hiring criterion is documented renovation experience backed by a written, inspection-driven scope. A contractor who quotes without inspecting is guessing at your budget.

Contractor vetting checklist:

  1. Verify licensing and insurance. Confirm the contractor holds a valid state contractor’s license and carries both general liability and workers’ compensation insurance. Ask for certificates, not just verbal confirmation.
  2. Check references and portfolio. Ask for three recent renovation references and photos of completed projects. Call the references and ask specifically about how the contractor handled unexpected findings.
  3. Review the written scope. The quote should itemize every line item, specify materials by name and grade, and include allowances for hidden work.
  4. Confirm the timeline and payment schedule. A reasonable deposit is 10–30% upfront. Be cautious of anyone asking for more than half the total before work begins.
  5. Understand the warranty. Surface warranties typically run 1–5 years depending on the material and contractor. Equipment warranties follow manufacturer terms. Get both in writing.
  6. Ask about the change-order process. How are unexpected findings documented and priced? A clear change-order process protects you from scope creep.

Using a contractor hiring checklist reduces the risk of hiring poorly qualified companies and gives you a consistent framework for comparing bids.

Red flags to watch for:

Contract line items to insist on:

Which refurbishment tasks can you safely DIY?

Minor cosmetic fixes and simple equipment swaps are reasonable DIY territory. Anything that touches the shell, structural repair, plumbing, electrical systems, or the final surface application needs a licensed professional.

Task DIY or Pro? Notes
Liner patching (vinyl pools) DIY Temporary fix; full replacement needed for major tears
Skimmer basket clearing DIY Basic maintenance, no tools required
Basic filter cleaning DIY Follow manufacturer instructions
Chemical balancing DIY Test weekly; use a reliable test kit
Clogged return line clearing DIY with caution Stop if pressure doesn’t resolve; call a pro
Plumbing leak repair Pro required Requires pressure testing and licensed plumber
Main drain replacement Pro required Safety code compliance and permit required
Shell crack repair Pro required Structural work; improper repair causes further damage
Resurfacing (plaster/pebble) Pro required Requires specialized equipment and technique
Electrical work (pump, lighting) Pro required Permit required; safety risk if done incorrectly

Many common pool repairs — liner patching, skimmer clearing, basic filter cleaning — are genuinely suitable for homeowners. Structural leaks and plumbing or electrical problems require professional diagnosis and repair.

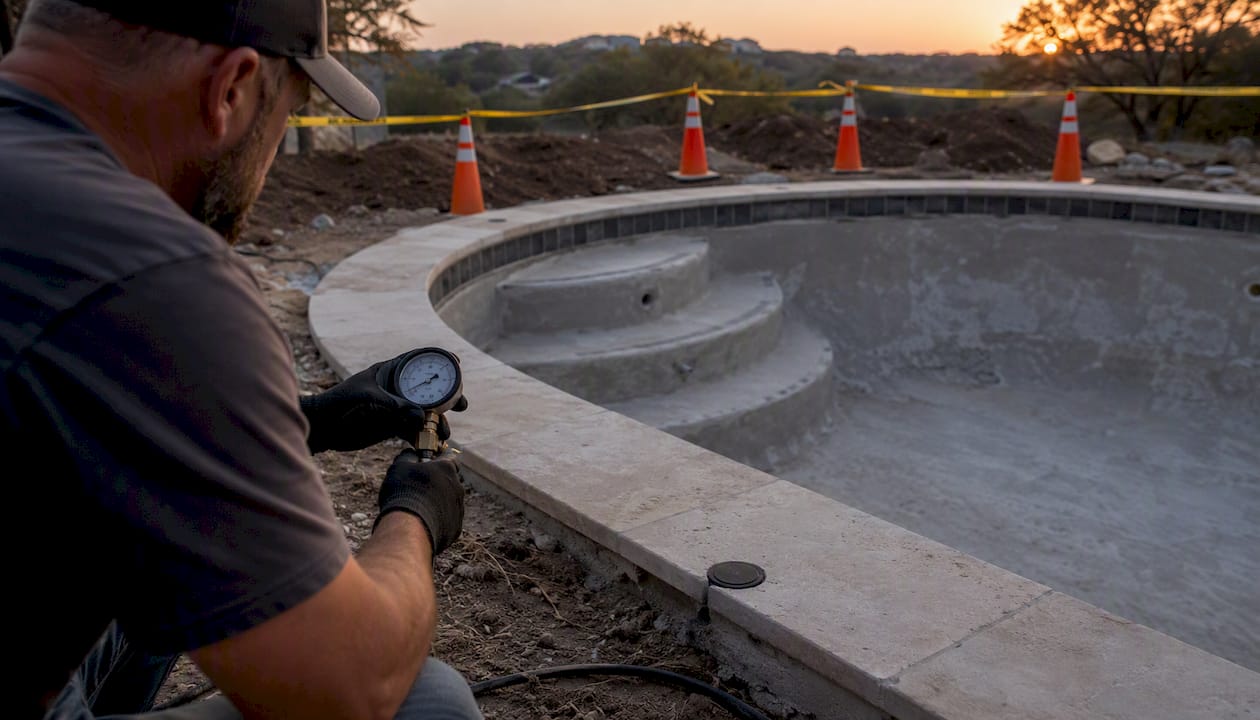

One important safety note: draining a pool without understanding hydrostatic pressure can cause the shell to pop out of the ground, especially in areas with high water tables. Never drain a pool without confirming it’s safe to do so with a qualified contractor first.

Contractor measuring hydrostatic pressure in drained pool

What contractors wish you knew before starting

The loudest symptom is rarely the actual problem. A stained surface might be hiding rebar corrosion. A slow leak might be a failing main drain line rather than a crack in the plaster. Contractors consistently say that homeowners who start with a professional inspection have smoother projects, fewer surprises, and better final results.

Common contractor pain points and how to avoid them:

Real-world example: a homeowner schedules a resurfacing project based on visible plaster wear. During demo, the crew finds a 6-foot section of corroded rebar along the shallow end wall. The repair adds three days and several thousand dollars to the project. With an inspection-driven scope and a written structural allowance in the contract, that finding is handled cleanly rather than becoming a dispute.

Pro Tip: Use the inspection report as a negotiating tool. When you receive contractor quotes, ask each one to address every finding in the report explicitly. Any contractor who dismisses inspection findings without explanation is a contractor to avoid.

How to maintain your pool after refurbishment

A fresh surface and new equipment are only as good as the maintenance routine that follows. The first 30 days after a new plaster or aggregate finish are the most critical — improper startup chemistry can etch or stain a new surface permanently.

Startup phase (first 30 days):

Ongoing maintenance habits that extend pool life:

Good chemistry habits protect the surface finish more than any other single factor. The sun does its best to bleach everything, and Central Texas summers push water chemistry hard. Staying on top of it means your new surface lasts closer to the top of its rated lifespan than the bottom.

Eco-friendly options for your pool refurbishment

Refurbishing an existing pool is already the greener choice compared to demolition and new construction, but there are several ways to reduce your pool’s ongoing environmental footprint during the renovation.

Energy efficiency:

Water conservation:

Chemical reduction:

If you’re interested in adding water features during your refurbishment, recirculating designs that reuse pool water rather than drawing fresh water are the most water-efficient option.

What we’ve learned from years of pool renovations

The homeowners who have the smoothest refurbishment experiences share one habit: they treat the inspection report as the project’s foundation, not as an optional formality. Every time we see a project go sideways, it usually traces back to a scope that was written before anyone really looked at the pool.

The other mistake we see regularly is timing. Homeowners call in April wanting to swim by Memorial Day. By then, permit offices are backed up, contractor schedules are full, and material lead times have stretched. The projects that go smoothly are the ones that start the inspection and planning process in the fall or early winter, well before the pressure of swim season.

One more thing worth saying plainly: refurbishment is not always the answer. If the shell has moved significantly, if soils have shifted, or if the original construction was poor enough that repairs would cost more than a new pool, we’ll tell you that. The goal is a pool you’ll enjoy for the next 20–30 years, not a project that delays the inevitable.

Longhorn Pools handles pool refurbishment from inspection to swim-ready

For Austin and Texas Hill Country homeowners, Longhorn Pools offers a straightforward path through the refurbishment process: we start with a documented inspection, build a written scope with explicit allowances for hidden work, manage all permits and local code requirements, and coordinate resurfacing with equipment upgrades so you never drain the pool twice.

Longhorn Pools

Our renovation work covers the full range: surface replacement in plaster, aggregate, and pebble finishes; tile and coping; equipment upgrades including variable-speed pumps, automation, and LED lighting; deck work; and water feature additions. We handle the sequencing, the subcontractors, and the inspections so you don’t have to.

If your pool has multiple aging systems, visible cracking, or you simply haven’t touched it in a decade, the right first step is a conversation. Visit our pool renovations page to see our work and request a consultation, or review our detailed renovation process to understand exactly what working with us looks like from start to finish.

The sources below were used to build this guide and are worth bookmarking for deeper research or local code verification.
