A clean pool contractor RFP process runs nine steps: prequalification (RFQ) → prepare RFP package → issue RFP with Q&A period → receive proposals → evaluate with a weighted scorecard → interviews and site visits → select and negotiate → sign contract with SLAs and warranty language → onboard to construction start. For most custom pool projects in Central Texas, this approach builds on the common eight-stage construction RFP process by adding a prequalification step at the start and a formal onboarding stage at the end. From first document to Notice to Proceed, expect several weeks depending on permit timing.
Here’s the full sequence at a glance:
- Prequalification (RFQ): a short period to screen a handful of contractors for licensing, insurance, bonding, and relevant portfolio
- RFP prep: a few weeks to assemble scope, drawings, specs, and submission instructions
- Solicitation and Q&A: a few weeks, including a pre-bid site visit and formal addenda
- Proposal review and scoring: a short period using a weighted scorecard
- Interviews and site visits: a few days for your top bidders
- Negotiation and contract signing: a short period
- Permitting and construction start: several weeks (Austin/Travis County permit timelines vary by project complexity)
The goal is comparable, line-item proposals and a signed contract that includes SLAs, a baseline site assessment, and warranty-preserving language. A well-structured RFP forces every bidder to quote the same scope, which is the single biggest thing you can do to make selection reliable.
Table of Contents
- What are the pool contractor RFP process steps, in order?
- How do you prequalify pool contractors before sending the full RFP?
- What should you include in the RFP package?
- How do you evaluate pool proposals fairly?
- What timeline and budget should you plan for?
- What goes into the final contract negotiation?
- What Austin and Hill Country site conditions affect your RFP?
- Key Takeaways
- What we see most often — and where owners go wrong
- Longhorn Pools can handle the heavy lifting for you
- Useful sources and further reading
What are the pool contractor RFP process steps, in order?

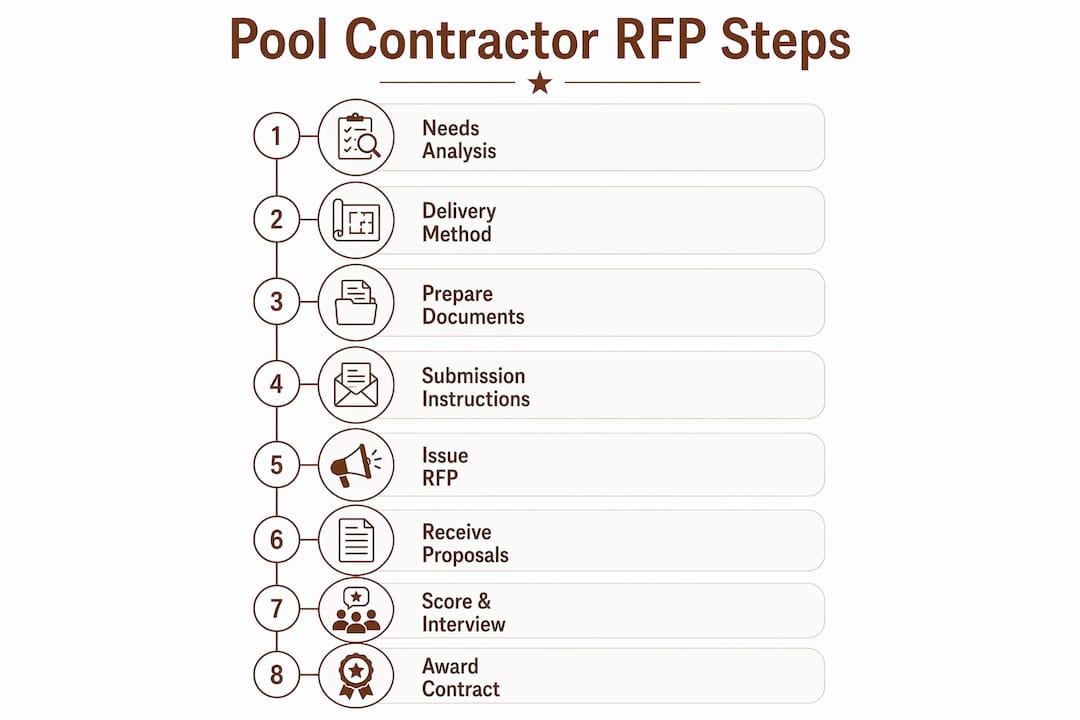

The construction RFP process commonly follows eight stages from need to award: needs analysis, scope selection, RFP drafting, distribution, pre-proposal conference, submission, evaluation, and contract negotiation. For a custom pool build or renovation in Central Texas, we add a prequalification step at the front and a formal onboarding step at the end.

Step 1: Needs analysis and budget ceiling. Before you write a single document, define what you actually want. New construction or renovation? Pool only, or pool plus spa, water features, and outdoor living? Set a realistic budget ceiling and identify your decision-maker, your designer or engineer if you have one, and your HOA contact if applicable.
Step 2: Choose a delivery method. Design-bid-build keeps design and construction separate. Design-build puts both under one contract. Negotiated delivery works well when you already have a trusted contractor and want to skip a formal bid. For most custom residential projects in Austin, design-build or negotiated delivery is faster and reduces coordination risk.
Step 3: Prepare RFP documents. Gather site photos, existing drawings, utility locate results, HOA rules, and any geotechnical data you have. These become attachments to your RFP package.

Step 4: Draft submission instructions and evaluation criteria. Publish your scoring weights up front. Bidders who see transparent criteria submit better proposals, and you have a defensible record if a decision is questioned later.
Step 5: Issue the RFP and run a pre-bid site visit. Distribute to your prequalified list. Schedule a mandatory or strongly encouraged site walkthrough so every bidder sees the same conditions. Answer all questions via formal written addenda so no bidder has an information advantage.
Step 6: Receive proposals and check compliance. Before scoring, confirm each submission includes a line-item price breakdown, equipment model numbers, proof of insurance, and all required forms. Non-compliant proposals get returned or disqualified.
Step 7: Score, shortlist, and interview. Apply your weighted scorecard. Invite your top two bidders for a short interview and a second site visit. Ask for a best-and-final offer (BAFO) if pricing is close.
Step 8: Award, negotiate, and sign. Issue a Notice of Award, negotiate final contract terms, and execute. Do not issue a Notice to Proceed until insurance and bonding are verified.
Step 9: Baseline site assessment and onboarding. Before any shovel hits the ground, complete a baseline site assessment documenting existing conditions. This protects both parties from hidden-condition disputes later.
“This final step isn’t about winning or losing; it’s about aligning on a shared goal — finalizing the contract sets the foundation for a successful partnership and project.” — Procore, RFPs in Construction
Pro Tip: For a complex custom build, use an invitational RFP limited to a few prequalified firms rather than an open call. You get better proposals and spend less time reviewing submissions from contractors who were never a real fit.
How do you prequalify pool contractors before sending the full RFP?
Prequalification saves time on complex projects by filtering for bonding capacity and relevant experience before you invest in a full RFP package. Send a short Request for Qualifications (RFQ) first.
Mandatory pass/fail items:
- Valid Texas contractor license (verify at the Texas Department of Licensing and Regulation)
- Certificate of Insurance (COI) showing general liability and workers’ compensation
- Proof of performance bonding capacity or surety confirmation
- Portfolio with at least two comparable completed projects (custom inground pools, renovations, or commercial builds)
- Local references from Austin or Hill Country clients
Desirable scored items:
- In-state staffing and subcontractor relationships
- Permit-handling experience in Austin/Travis County or surrounding Hill Country jurisdictions
- Equipment maintenance capacity and warranty service relationships
- Emergency-response capability for commercial or HOA clients
Documents to request at the RFQ stage:
| Document | Purpose |
|---|---|
| Completed RFQ form | Confirms interest and basic qualifications |
| Certificate of Insurance | Verifies liability and workers’ comp coverage |
| Texas contractor license number | Confirms legal authority to perform the work |
| Project references (2–3 minimum) | Validates relevant experience |
| Sample contract terms | Flags unusual clauses early |
| Evidence of financial stability | Reduces mid-project abandonment risk |
If a firm is missing a license, COI, or bonding capacity, decline to issue the full RFP. No exceptions. A contractor who cannot clear a pass/fail screen is not a contractor you want managing a build of significant cost on your property.
What should you include in the RFP package?
The RFP package is where vague projects become expensive ones. Every ambiguity you leave in the scope document will come back as a change order. A strong package forces apples-to-apples proposals and gives you something to hold a contractor to after signing.
| RFP Section | What to Include |
|---|---|
| Executive summary | Project goals, site address, delivery method, and owner contact |
| Project scope and objectives | Pool type, size, features, finish preferences, and renovation items |
| Existing site data | Photos, survey, utility locate, HOA rules, any geotechnical data |
| Technical specifications | Shell method, equipment brands/models, finish materials, structural assumptions |
| Schedule and milestones | Target start date, key milestone dates, substantial completion deadline |
| Submission instructions | Format, deadline, required forms, and contact for questions |
| Evaluation criteria and weights | Published scoring categories and point allocations |
| Sample contract terms | Warranty language, change-order process, SLA benchmarks |
| Permit/inspection responsibilities | Who pulls permits, who attends inspections, who pays fees |
Require a line-item price breakdown separating excavation, shell, plumbing, equipment, decking, and startup. Ask for equipment model numbers. A proposal that bundles everything into one lump sum is impossible to compare and easy to manipulate with substitutions after signing. For luxury pool features like LED lighting systems, water features, or automation packages, specify the brand and model you expect so every bidder prices the same thing.
“Make sure that all project details are in writing to avoid misunderstandings. The contract must include a description of the work and the materials and equipment that will be used.” — California Contractors State License Board
This principle applies in Texas just as firmly. Clear scopes reduce change orders and protect your warranty coverage.
How do you evaluate pool proposals fairly?
Procurement is a long-term protective decision. Successful buyers avoid selecting the lowest bid and instead use a weighted scorecard that assigns point values to credentials, operational depth, and technical fit.
Here’s a sample point allocation for a residential or high-end pool project:
| Category | Points |
|---|---|
| Operational depth and staffing | 15–20 |
| Documentation and transparency | 15–20 |
| Permitting and regulatory fit | 10–15 |
| Price | 10 |
Price is given a relatively low weighting in the overall evaluation. That is intentional. A contractor who scores 85 on technical criteria but comes in 15% cheaper than a 95-point competitor is still the riskier choice on a custom build.
Red flags during evaluation:
- No line-item breakdown (lump-sum only)
- Vague warranty language (“standard manufacturer warranty” with no documentation)
- Refusal to include SLAs or emergency response commitments
- Evasive answers about who pulls permits or handles inspections
Pro Tip: Before finalizing scores, call two references for each of your top bidders. Ask specifically about change-order frequency, communication during construction, and whether the finished product matched the proposal. Those calls often change the ranking.
For contractor interview questions that go deeper than the standard checklist, a structured interview guide helps you get consistent, comparable answers from each finalist.
What timeline and budget should you plan for?
For a custom pool build or renovation in Central Texas, here are realistic durations across both the RFP and construction phases:
| Phase | Typical Duration |
|---|---|
| RFP prep (scope, docs, drawings) | 2–3 weeks |
| Solicitation and Q&A period | 3–4 weeks |
| Proposal evaluation and scoring | a short period |
| Interviews, BAFO, negotiation | a short period |
| Permitting (Austin/Travis County) | 4–8 weeks (varies by complexity) |
| Excavation and shell | 3–6 weeks |
| Equipment rough-in and plumbing | 2–4 weeks |
| Finish, startup, and punch list | 2–4 weeks |
For seasonal projects, issue your RFP early in the year. Top contractors fill their schedules by March, so a January or February RFP issue date gives you the best field of bidders for a summer construction start.
On budget, plan for a contingency of 10–20% depending on site risk. Hill Country lots with caliche, rock, or drainage challenges sit at the higher end. A strong proposal separates phases and uses milestone billing: deposit, excavation/shell start, equipment rough-in, finish/startup, and final retention. Avoid any contract where payments run ahead of completed work.
What goes into the final contract negotiation?
Contract negotiations work best when both parties focus on aligning goals rather than treating it as a win-lose fight. You want a clear scope, a realistic schedule, and legal protections. The contractor wants a fair price and a client who communicates clearly. Both are achievable.
Essential contract mechanics:
- Baseline site assessment completed before work begins
- Line-item pricing with equipment model numbers
- Defined change-order process (written, signed by both parties before work proceeds)
- SLA benchmarks: 2-hour emergency response, 24-hour incident reporting
- Warranty preservation language and documentation requirements
- Permit and inspection responsibilities spelled out explicitly
- Dollar threshold ($500–$1,000) for unquoted repairs, with a defined approval path
Red-flag clauses to push back on:
- “Standard equipment” with no brand or model specified
- Open-ended allowances with no cap
- No defined emergency response window
- Absent or vague warranty documentation requirements
For a deeper look at how remodeling contracts work and what clauses matter most, that resource translates directly to pool contracting.
“Any changes made to the project in materials, completion date, and equipment should be made in writing. The change order should be clearly worded and signed by both parties.” — California Contractors State License Board
Post-award checklist: Notice of Award, signed contract, baseline site assessment report, verified insurance and bonding certificates, and a Notice to Proceed with milestone dates attached.
What Austin and Hill Country site conditions affect your RFP?
Central Texas throws a few curveballs that contractors from other markets do not always price correctly. Build these into your scope language so bidders account for them in their proposals, not in change orders six weeks into the job.
Common local site conditions:
- Variable caliche and limestone rock layers that require specialized excavation equipment or blasting
- Drainage and erosion challenges on sloped Hill Country lots
- Expansive clay soils in parts of Austin that affect shell design and structural assumptions
- Tight access for large excavation equipment on infill lots or properties with mature trees
Permitting in Austin and Travis County typically runs 4–8 weeks for residential pool permits, though complex projects or those requiring drainage plan review can run longer. HOA architectural review adds another layer: most Hill Country HOAs have specific rules on finish colors, fencing height, and equipment screening that affect your spec choices. Get those requirements in writing before you draft the RFP.
Pro Tip: Require shortlisted bidders to submit a brief pre-bid site assessment report as part of their proposal. A contractor who walks the site and documents existing drainage patterns, access constraints, and soil observations is a contractor who will price the job accurately. Those who skip the site visit tend to find surprises later.
“Require a pre-bid baseline site assessment report as a contract prerequisite to capture existing issues and prevent hidden-condition change orders.” — Pool Management Inc., Commercial Pool Management Buyer’s Guide
For inground pool excavation preparation specific to Central Texas conditions, that’s worth reviewing before you finalize your scope language.
Key Takeaways
A complete pool contractor RFP process requires prequalification, a detailed scope package, a weighted scorecard, and a contract with SLAs and baseline site assessment before construction starts.
| Point | Details |
|---|---|
| Run an RFQ first | Screen 4–6 contractors for licensing, insurance, bonding, and portfolio before issuing the full RFP. |
| Require line-item pricing | Separate excavation, shell, equipment, and decking to make proposals comparable and hold contractors accountable. |
| Use a weighted scorecard | Assign only 10 points to price; weight credentials, experience, and documentation more heavily. |
| Build in local site conditions | Require bidders to address caliche, drainage, and access in their proposals to avoid Hill Country change orders. |
| Longhorn Pools as your partner | Longhorn Pools provides baseline site assessments, line-item proposals, and permitting support for Austin and Hill Country builds. |
What we see most often — and where owners go wrong
Most RFP mistakes happen before the first proposal arrives. Owners skip the prequalification step, send a vague scope to six contractors, and end up with six completely different proposals they cannot compare. One bid covers excavation and shell only. Another bundles everything including landscaping. A third uses a lump sum with no equipment list. At that point, you are not evaluating contractors — you are trying to reverse-engineer what each one actually quoted.
The second most common problem is missing baseline documentation. A contractor who starts work without a site assessment has no reference point for what was pre-existing. When drainage issues or rock layers appear mid-excavation, there is no record of what conditions existed before the shovel went in. That is where disputes start.
Warranty language is the third gap. Vague phrases like “standard warranty” or “manufacturer coverage” mean nothing if the contractor installs a substituted equipment brand or skips a required inspection step. Insist on named equipment models, documented inspection sign-offs, and explicit warranty preservation requirements in the contract.
The Q&A period during solicitation is also underused. Publish every question and answer as a formal addendum so all bidders see the same information. It takes an extra hour of your time and saves weeks of back-and-forth after proposals arrive.
Longhorn Pools can handle the heavy lifting for you
If running a full RFP feels like more process than your project needs, Longhorn Pools offers a more direct path. We serve homeowners, HOAs, and commercial clients across Austin and the Texas Hill Country with custom pool construction and full renovation services — including the baseline site assessment, line-item proposals, permitting coordination, and contract negotiation support that the RFP process is designed to produce.

You get a transparent, documented process without managing it yourself. Our proposals break out excavation, shell, equipment, decking, and startup as separate line items. We handle Austin and Hill Country permit submissions and know the local soil and drainage conditions that catch other contractors off guard. Ready to skip the paperwork and get a real proposal? Request a consultation and we’ll walk your site, document existing conditions, and give you a proposal you can actually compare.
Useful sources and further reading
These are the primary references and resources used throughout this guide. Save them for your procurement records.
- Commercial Pool Management: A Complete Buyer’s Guide — Pool Management Inc. Covers weighted evaluation, SLA benchmarks, and baseline assessment requirements.
- What Is an RFP in Construction? — The Write Direction. Eight-stage RFP process and prequalification guidance.
- RFPs in Construction — Procore. Contract negotiation alignment and Q&A addenda best practices.
- How to Read a Pool Proposal — Back Bay Pools. Line-item breakdown guidance and equipment model number requirements.
- Before Swimming Pool Construction — California Contractors State License Board. Contract basics, change-order requirements, and payment schedule guidance applicable across markets.
- Inground Pool Installation in Austin — Longhorn Pools. Local construction service page and consultation starting point.
- Pool Construction Material Options — Longhorn Pools. Shell methods and material comparisons for technical spec writing.
- High-End Pool Design Elements — Longhorn Pools. Luxury feature and finish reference for RFP scope statements.
Keep all RFP documents, addenda, scorecards, reference call notes, and signed contracts in a single project file. That record protects your warranty coverage and gives you a clear paper trail if a dispute arises during or after construction.
