Inground pool excavation preparation is the comprehensive process of site assessment, utility locating, soil evaluation, and layout marking required before any digging begins. Skip these steps and you risk hitting a gas line, losing structural integrity, or watching your budget spiral from unexpected rework. At Longhornpools, we’ve seen what happens when homeowners rush straight to the excavator. The projects that go smoothly are the ones where the groundwork, literally and figuratively, was done right. This guide walks you through every preparation step so your pool installation starts on solid footing.
What steps are involved in inground pool excavation preparation?
Good pool site preparation follows a clear sequence. Rushing any step creates problems that compound later, and the cost of fixing them mid-dig is always higher than preventing them upfront.

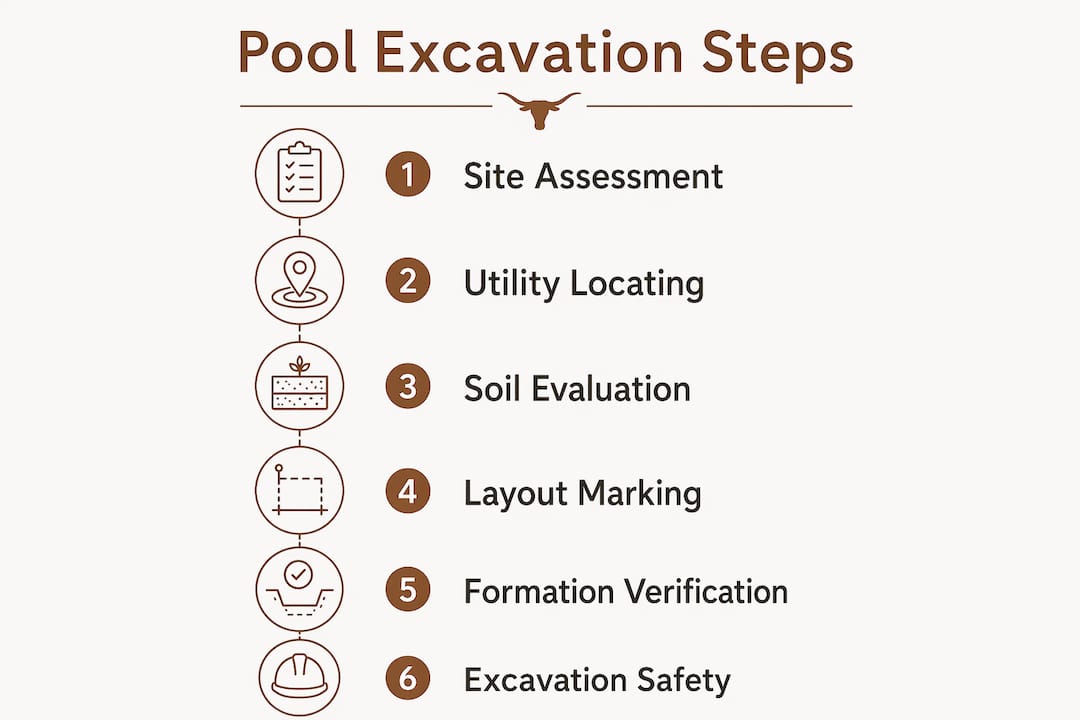

Here’s the order that works:
- Clear the site. Remove vegetation, topsoil, and any surface debris from the pool footprint and surrounding work area. You need a firm, stable base before anything else happens.
- Submit a utility locate request. Call 811 or submit a request online before you dig. Allow 2–10 working days for utility companies to mark underground lines. This is not optional.
- Apply for permits. Pool construction requires building permits in virtually every Texas municipality. Check Austin’s pool building regulations early, because approval timelines vary and can delay your start date.
- Evaluate equipment access. Walk the route from the street to your pool site. Measure gate widths, overhead clearances, and any obstacles. A standard excavator needs at least 36 inches of clearance, and many residential yards fall short.
- Mark the pool footprint. Use stakes, chalk lines, or spray paint to transfer the pool design from your drawings to the ground. This gives the excavator operator a precise target.
- Assess drainage and slope. Identify which direction water flows across your yard and note any low spots that collect standing water.
A few things to keep in mind during this phase:
- Utility markings show approximate locations, not exact ones. Respect an 18-inch tolerance zone on each side of every marked line during digging.
- Permit applications often require a site plan, so have your pool design finalized before you apply.
- Access constraints discovered after equipment arrives cause costly delays. Solve them before day one.
How do soil conditions and drainage impact pool excavation?
Soil type is the single biggest variable in excavation difficulty and long-term pool stability. Documenting your soil type before digging begins lets you anticipate problems rather than react to them.
Here’s what each common soil type means for your project:
- Clay soil holds water and swells when wet. It can destabilize excavation walls and create hydrostatic pressure against the pool shell after installation.
- Sandy soil drains well but shifts easily. Excavation walls in sandy soil can collapse without proper shoring, and the base may need compaction work before the pool structure goes in.
- Loam is the most cooperative soil for pool excavation. It holds its shape and drains at a reasonable rate.
- Rocky soil is the most expensive to excavate. Hard rock requires specialized equipment or blasting, and costs can increase significantly compared to standard soil conditions.
Drainage evaluation goes hand in hand with soil assessment. Walking your property during rainfall is the most reliable way to identify low-lying areas that collect water. Those spots need correction before excavation begins, not after.
Pro Tip: If your yard has a history of standing water after rain, bring in a structural engineer or geotechnical consultant before finalizing your pool design. Discovering a drainage problem after excavation starts costs far more than a pre-construction consultation.

Fill material used to correct low spots or level the site should be compacted in 6–8 inch layers to 95% maximum density. Loose fill settles over time and creates structural stress on the pool shell.
Why does accurate layout marking matter before you dig?
Layout marking and formation-level verification are two separate tasks. Most homeowners understand the first one. Far fewer understand the second, and that gap causes expensive problems.
Layout marking transfers your pool design from paper to the physical site. Stakes define the perimeter, chalk lines show depth transition zones, and spray paint marks reference points the excavator operator follows. Using datum reference points to transfer scaled drawings to the site ensures the pool ends up in the right location with the right dimensions.
Formation-level verification goes deeper. It confirms that the excavated base sits at the correct engineered depth and has the bearing capacity to support the pool structure. Adjustments made late in excavation increase complexity and cost significantly. Getting the formation level right the first time is not a detail. It’s the foundation of everything that follows.

| Task | Purpose | Tool used |
|---|---|---|
| Perimeter staking | Defines pool boundary on site | Timber stakes, string line |
| Depth zone marking | Shows shallow end, deep end transitions | Spray paint, chalk |
| Datum reference point | Anchors all vertical measurements | Laser level, benchmark peg |
| Formation-level check | Confirms engineered base depth and bearing | Laser level, rod and level |
Pro Tip: Set a permanent datum peg at the start of the project and reference every depth measurement back to it. If the peg moves or gets knocked out, re-establish it before any further digging. One lost reference point can throw off the entire excavation.
What logistics and safety steps must be addressed before excavation?
Excavation logistics are where well-planned projects separate from chaotic ones. The physical act of digging is straightforward. Getting the right equipment to the right place, removing the spoil efficiently, and keeping the site safe requires planning that most homeowners underestimate.
Equipment access is the first logistics question. Tight yards may require a mini excavator instead of a standard machine, or a crane to lift equipment over fences. Restricted access routes should be identified and solved before equipment arrives, not on the morning of excavation.
Spoil removal is the second major logistics factor. A standard inground pool generates a large volume of excavated soil. Spoil is typically loaded onto dump trucks and hauled off-site, and disposal fees add to your project budget. Plan the truck route in advance and check whether your municipality requires a permit for street access during hauling.
Safety during excavation comes down to one non-negotiable rule:
Never dig within 18 inches of a marked utility line without hand-digging first. Utility markings show approximate locations. The tolerance zone exists because the actual line could be anywhere within that range.
A few other safety points worth noting:
- Keep children and pets off the site during active excavation.
- Fence open excavations at the end of each workday.
- Check that your contractor carries liability insurance and workers’ compensation before work begins.
- Confirm that all permits are posted on-site as required by local code.
How do you handle water and drainage challenges during pool site preparation?
Groundwater is the variable that surprises homeowners most often. A site can look perfectly dry during the planning phase and reveal a high water table the moment excavation begins. High groundwater tables require dewatering to stabilize the excavation and prevent the walls from collapsing.
Here’s how to manage water proactively:
- Assess groundwater depth before digging. A geotechnical report or a simple observation well can reveal the water table level. This information shapes your excavation plan and your pool shell design.
- Deploy sump pumps for active dewatering. Sump pumps placed at the lowest point of the excavation remove water as it accumulates. They’re the most common dewatering method for residential pool projects.
- Consider wellpoint systems for high water tables. Wellpoints are a network of small pipes driven into the ground around the excavation perimeter. They draw water away from the dig zone continuously and are used when sump pumps alone aren’t sufficient.
- Grade the surrounding site to slope away from the pool area. Surface water should drain away from the excavation, not into it. A minimum slope of 1–2% away from the pool edge is the standard target.
- Connect to local drainage systems where required. In some Austin-area neighborhoods, local drainage ordinances require that pool drainage connects to an approved system. Check with your municipality before finalizing your drainage plan.
A pool inspection from a qualified professional before breaking ground can identify drainage risks that aren’t visible to the untrained eye.
Key Takeaways
Thorough inground pool excavation preparation, covering soil assessment, utility locating, layout marking, and drainage planning, is the single most effective way to prevent costly delays and structural problems during pool installation.
| Point | Details |
|---|---|
| Utility locating is non-negotiable | Call 811 and allow 2–10 working days before any digging begins. |
| Soil type drives excavation cost | Clay, sandy, rocky, and loam soils each require different approaches and budgets. |
| Layout marking and formation level are separate tasks | Stakes mark boundaries; formation-level verification confirms the engineered base depth. |
| Access and spoil removal need early planning | Tight yards may require specialized equipment; disposal fees add to project costs. |
| Dewatering prevents excavation failure | Sump pumps and wellpoints stabilize wet sites before and during digging. |
What I’ve learned from watching rushed excavations go sideways
The projects that cost the most to fix are almost never the ones with complex designs. They’re the ones where someone skipped the preparation phase because they were eager to get started. I’ve seen it more times than I can count.
Utility locating is the step people skip most often. The logic is usually “I know roughly where the lines are.” That logic fails regularly, and the consequences range from a broken cable line to a ruptured gas main. Proactive utility verification is not bureaucratic box-checking. It’s the step that keeps people safe and keeps projects moving.
Soil evaluation is the second most skipped step. Central Texas Hill Country terrain is particularly unforgiving. You can have clay in one corner of a yard and caliche rock two feet down in another. A structural engineer or geotechnical consultant brought in early costs a fraction of what mid-excavation surprises cost. The inground pool installation process in this region rewards patience during the prep phase.
My honest advice: treat preparation as the project, not the preamble. The excavation itself is fast. The preparation is where you earn a smooth build.
— Mark
Longhornpools handles the hard parts of pool excavation

Site preparation is where pool projects succeed or fail, and it’s also where having an experienced team makes the biggest difference. Longhornpools manages every step of the preparation process for Austin-area homeowners and property developers, from soil assessment and utility coordination to layout marking and drainage planning. We know Central Texas terrain because we build in it every day.
If you’re ready to move from planning to building, our custom pool installation services cover the full scope of site prep and excavation management. You can also explore our Signature Series pool designs to see what’s possible for your property. Reach out to Longhornpools for a consultation and get your project started the right way.
FAQ
How far in advance should I call 811 before pool excavation?
Submit your utility locate request at least 2–10 full working days before excavation begins. Wait for all utility markings to appear before any digging starts.
What soil type is hardest to excavate for an inground pool?
Rocky soil is the most difficult and expensive to excavate. It often requires specialized equipment or blasting, which adds significant cost compared to clay, sandy, or loam conditions.
Do I need a permit before digging a pool in Austin?
Yes. Pool construction in Austin requires a building permit before excavation begins. Check current requirements through the City of Austin or consult a local pool builder familiar with municipal codes.
What is formation-level verification and why does it matter?
Formation-level verification confirms that the excavated base sits at the correct engineered depth with sufficient bearing capacity. Errors caught late in excavation cost significantly more to correct than those identified before digging.
How do I manage groundwater during pool excavation?
Deploy sump pumps at the lowest point of the excavation to remove water as it accumulates. For high water tables, wellpoint systems provide continuous dewatering around the excavation perimeter.
