Resort-style pools are defined by a multi-phase construction process that fuses structural engineering with luxury design to create permanent outdoor environments. Understanding how resort style pools are built helps homeowners and developers make smarter decisions before a single shovel hits the ground. These projects typically span 8–14 weeks from groundbreaking to final inspection. That timeline reflects the complexity involved: permits, excavation, steel reinforcement, gunite application, and finish work all require precise sequencing. The industry term for this category is “custom inground pool construction,” and the resort-style label describes the design intent, not a separate building method. Get the process right from the start, and the result is a backyard that genuinely feels like a five-star property.

How resort style pools are built: the key phases

The phased construction process moves from site evaluation through mechanical installation in a fixed sequence. Skipping or rushing any phase creates problems that are expensive to fix after the shell is cured.

  1. Site evaluation and 3D design. A qualified builder surveys soil conditions, drainage patterns, utility lines, and property setbacks before drawing a single line. Most luxury builders now use 3D modeling software to render the finished pool in context with your home and landscaping. You approve the design digitally before excavation begins, which prevents costly mid-project changes.

  2. Permitting. Permits are pulled before any ground is broken. Inspections are mandatory at multiple stages: after excavation, after steel placement, after plumbing and electrical rough-in, and at final completion. Skipping this step is not an option on a legitimate build.

  3. Excavation. A crew marks the pool’s exact footprint using stakes and spray paint, then an excavator removes soil to the engineered depth. On sloped Hill Country lots, this phase can take several days and may require blasting through limestone.

  4. Steel rebar framework. Workers tie a grid of steel rebar inside the excavated shell. Rebar is spaced 6–12 inches apart and bound at intersections to resist both soil pressure from outside and water pressure from inside. This grid is the skeleton that keeps the shell from cracking over decades.

  5. Plumbing and electrical rough-in. PVC pipes for suction, return, and drainage lines are set inside the rebar cage before any concrete is applied. Conduit for lighting, automation wiring, and heating runs alongside the plumbing. Getting these placements right the first time is critical because they are permanently encased in concrete.

  6. Gunite or shotcrete application. A pneumatic hose shoots a dry or wet concrete mix at high velocity over the rebar framework. The nozzle operator holds the hose at a 90-degree angle to the surface to prevent hollow spots, called honeycombs, from forming inside the shell. The shell then cures for a minimum of 28 days before finish work begins.

  7. Tile, coping, and plaster. Waterline tile is set first, followed by coping stones along the pool’s edge. The interior surface receives a finish coat of plaster, pebble aggregate, or quartz. Each material choice affects both aesthetics and long-term maintenance.

  8. Decking and equipment installation. Concrete, travertine, or composite decking surrounds the pool. Pumps, filters, heaters, and automation controllers are mounted in a dedicated equipment pad, then connected to the rough-in plumbing and electrical.

Pro Tip: Ask your builder to show you the gunite test results. Reputable crews pull core samples from the cured shell and test them for compressive strength. If a builder cannot produce those numbers, that is a red flag.

What structural standards make a resort pool last?

The shell’s durability depends on hitting specific material and placement standards, not just on using good-looking finishes. Properly placed gunite shells target 4,000–5,000 PSI compressive strength. That range is the threshold at which concrete resists the constant lateral pressure of surrounding soil and the hydrostatic pressure of water inside the shell.

Structural element Standard or specification
Concrete compressive strength 4,000–5,000 PSI minimum
Rebar grid spacing 6–12 inches on center
Gunite nozzle angle 90 degrees to surface
Curing period before finish 28 days minimum
Waterproofing layers Applied before plaster coat

Rebar placement is where many budget builds cut corners. Precise spacing and binding techniques are what allow the steel grid to distribute load evenly across the entire shell. A grid that is tied loosely or spaced too wide creates stress points that eventually crack.

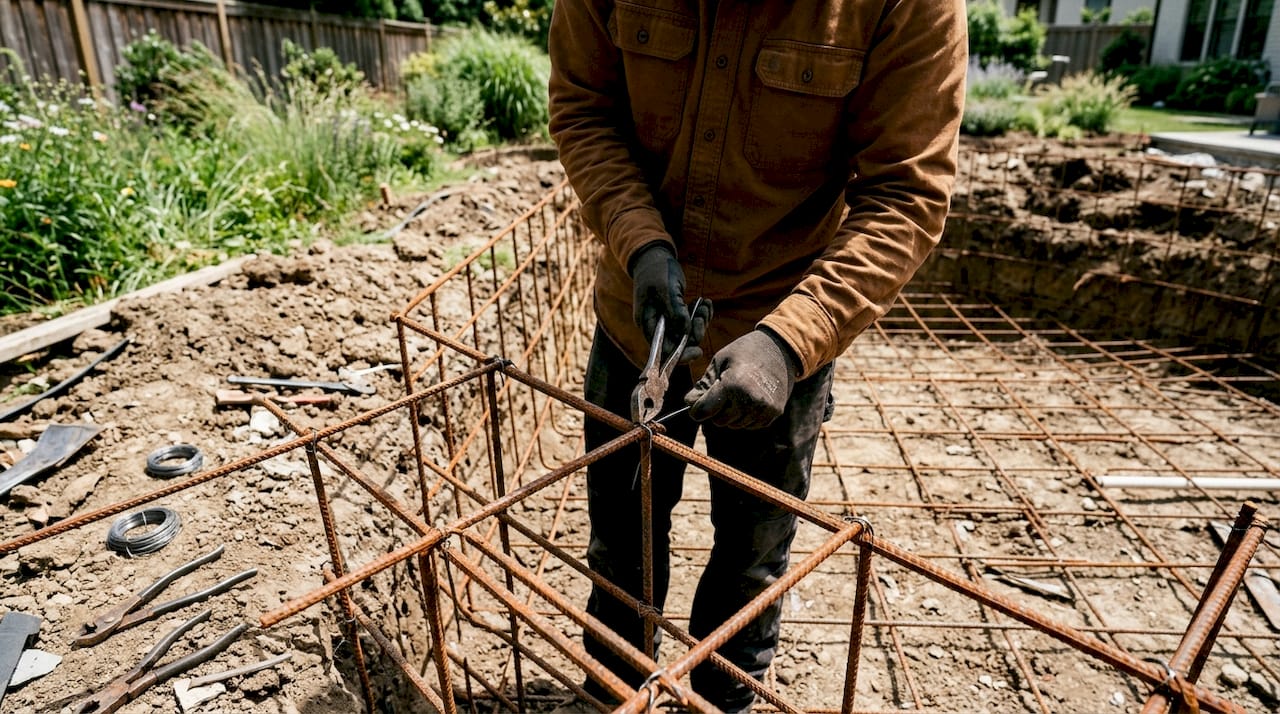

Technician tying rebar for pool structure

Shotcrete, the wet-mix variant of gunite, sets rapidly and achieves high density. Shotcrete favors complex shapes and sloped sites because the mix adheres immediately on contact, making it ideal for the irregular terrain common in Central Texas Hill Country builds. After the shell cures, a waterproofing membrane or bonding agent is applied before the plaster coat goes on. This layer is the last line of defense against slow leaks that can undermine the surrounding soil over years.

Coping and decking materials also carry structural responsibility. Travertine and natural stone handle thermal expansion better than poured concrete in climates with wide temperature swings. Slip-resistant finishes on decking are not just a comfort feature. They are a code requirement in most jurisdictions.

Infographic illustrating resort pool construction steps

Pro Tip: Request a copy of the rebar inspection report from your local building department before the gunite crew arrives. That document confirms the steel placement passed inspection, and it protects you if a dispute arises later.

How do design principles create an authentic resort feel?

A resort-style pool is not just a larger pool with more features. Luxury pools compose water, hardscape, lighting, and architecture into a single cohesive environment. The design intent drives every material and placement decision from the first sketch forward.

The most effective resort pool designs use zoning to organize the space. Multiple zones provide gathering areas, quiet retreats, and visual focal points that give the environment depth and variety. Think of it like a well-designed hotel lobby: there is a place to socialize, a place to decompress, and a centerpiece that draws the eye.

Key design elements that define the resort experience:

Material cohesion ties all of these elements together. When the coping stone, decking, and water feature rock share the same color family and texture range, the space reads as intentional rather than assembled from a catalog. That cohesion is what separates a luxury build from an expensive one.

What should homeowners know before breaking ground?

Planning a resort-style pool involves more than choosing finishes. The practical side of the project, from permits to long-term upkeep, shapes how much you enjoy the finished product.

For a deeper look at local code requirements, the Austin pool building regulations guide covers setback rules, barrier requirements, and inspection timelines specific to the metro area.

Key Takeaways

Resort-style pools require structural precision, coordinated design, and long-term planning to deliver a genuine luxury experience that holds up over decades.

Point Details
Construction follows a fixed sequence Skipping or rushing any phase creates structural or aesthetic problems that are costly to correct.
Shell strength is measurable Target 4,000–5,000 PSI compressive strength and verify it with test results before accepting the build.
Design zoning defines the resort feel Separate gathering, retreat, and focal-point zones to create depth and variety in the space.
Equipment placement is a design decision Plan pump and filter access during the design phase to avoid expensive maintenance complications later.
Material choices affect long-term cost Pebble finishes, travertine decking, and freeze-protection automation reduce service costs over the pool’s life.

What I’ve learned building pools that actually feel like resorts

The biggest misconception I run into is that a resort-style pool is mostly about features. Add a waterfall, a grotto, a tanning ledge, and you have a resort pool. That is not how it works.

What actually creates that feeling is proportion and flow. A grotto that is too large for the pool shell looks like a boulder dropped in the wrong yard. A swim-up bar positioned against the wrong wall blocks the sightline to the rest of the space. Luxury pool design requires design literacy as much as technical skill to translate a client’s vision into something that functions beautifully every day.

The builds that genuinely impress people are the ones where you cannot immediately identify what makes them feel special. The materials, the planting, the lighting, and the water all read as one thing. A luxury pool is a composed living environment, not a collection of expensive parts. That takes a builder who thinks about the whole picture from day one, not one who adds features on request.

The other thing I tell every homeowner: the decisions you make in the design phase cost you nothing to change. The decisions you make after the gunite is cured cost a lot. Spend the time upfront. It is always worth it.

— Mark

Longhorn Pools and your resort-style build

Longhorn Pools designs and builds custom resort-style pools across Austin and the Texas Hill Country, from the first site evaluation through final equipment commissioning.

https://longhornpools.com

Every project starts with a free 3D design session so you can see the finished pool in context with your home before any ground is broken. Longhorn Pools handles permitting, structural engineering, gunite application, and finish selection in-house, which keeps the project on schedule and the quality consistent. If you are ready to see what a true resort-style build looks like, the Signature Series showcases Longhorn Pools’ highest-level custom work, with examples of zoned layouts, integrated water features, and full outdoor living environments built for Central Texas conditions.

FAQ

How long does it take to build a resort-style pool?

Most resort-style pool builds take 8–14 weeks from groundbreaking to completion. Permit delays, weather, and material lead times can extend that timeline.

What construction method is used for resort-style pools?

The gunite or shotcrete method is the industry standard for custom inground pools. Concrete is sprayed at high velocity over a steel rebar framework, then cured for at least 28 days before finish work begins.

What compressive strength should a pool shell reach?

A properly built gunite shell should achieve 4,000–5,000 PSI compressive strength. That range ensures the shell withstands soil pressure and long-term water load without cracking.

Do resort-style pools require special permits?

Yes. Permits and inspections are required at multiple stages: after excavation, after steel placement, after plumbing and electrical rough-in, and at final completion. Your builder files the applications, but you should track each sign-off.

What finishes work best for a resort-style pool interior?

Pebble aggregate and quartz finishes outperform standard plaster in durability and stain resistance. They cost more upfront but reduce resurfacing frequency and look better longer in high-use pools.
